Pool Renovation & Retrofit

Pool Renovation Planning Guide

How to scope a pool renovation; condition assessment, deciding what to replace, sequencing surface and equipment work, and coordinating retrofit additions.

Opening the same deck or plumbing twice costs another demolition. Compare that repeat-access cost with keeping the item. Do not call the renovation the cheapest moment in every project.

Direct answer

Plan a renovation from a condition assessment, then scope, concealed work, finishes, and handover. This is a planning check, not a general construction instruction. Sequence follows the shell, finish, and equipment manuals and the site, including groundwater and shell risk.

Scroll sideways to see every column on a narrow screen.

StepPlanning checkDeliverableNot this page
AssessLeaks, shell, plumbing, electrical, equipmentSurvey recordA construction method
ScopeKeep, repair, or replaceReason for each itemReplace because of age alone
Concealed workTests before the next layerAccepted photos and readingsA finish that covers an open test
Finish and handoverSurfaces, then startup recordsAs-built and baseline readingsA promised duration
Drained swimming pool during a renovation with coping removed
Editorial photograph generated for this guide.

Key takeaways

  • Assess before you scope; leaks, plumbing condition and electrical compliance determine the real project.
  • Order is a planning check. Adjust it to the shell, finish, and equipment manuals and to site conditions, including groundwater and shell movement.
  • While access is already open, compare the cost of doing the work now with the cost of demolishing the same finishes later. That comparison is conditional.
  • Old pools rarely match old drawings; measure and verify before committing to any retrofit dimensions.

Renovations differ from new builds in one fundamental way: the project starts with unknowns already buried in the ground. Use this page as a planning check: assessment, scope, concealed work, finish, then handover. It is not a general construction instruction. Adjust the order to the shell, finish, and equipment manufacturer requirements and to the site.

Decision diagram splitting keep, repair, and replace from condition, compatibility, remaining life, and lifecycle cost
Planning diagram for keep, repair, or replace. It is not a construction sequence and not a site photograph.

Stage 1: Condition assessment

Before scoping anything, establish:

  • Water tightness: pressure-test suspect plumbing, investigate persistent water loss, and log a 24-hour comparison in the pool bucket test results record before draining;
  • Structure: shell cracks, delamination, coping and deck movement;
  • Plumbing: material, diameter and condition; old undersized suction lines cap what any new pump can do;
  • Electrical: bonding, protection and code compliance. CPSC Pool Safely materials are a United States safety reference for barriers, drains, and alarms. Remedy items when the applicable local rule requires it once work begins. This page does not turn that U.S. campaign into a rule for every country.
  • Equipment: age, efficiency and parts availability for each item in the circulation loop;
  • Safety: barriers, drain covers and alarms against current requirements.

Old drawings deserve suspicion: verify dimensions on site before any component that depends on them (especially retrofit cover feasibility) is priced.

Make the survey evidence part of the scope package. Use photographs keyed to a plan, pressure-test results, dimensions, equipment nameplate details and a list of areas that could not be inspected. Separate observed defects from suspected causes. A wet area near a pipe route, for example, is evidence to investigate rather than proof of which joint failed.

For concealed work, state the next inspection step and who owns it. This keeps a provisional allowance from being mistaken for a confirmed repair scope.

Copy this survey record. The headings are the deliverable for the assessment.

Deliverable: one filled row for each finding, including anything that could not be inspected before the pool is drained.

Stage 2: Scope decisions

Decision Guidance
Repair vs renovate Compare recurring repairs with one planned scope. Do not treat age by itself as the reason.
Surfaces only vs systems too Compare condition, compatibility, remaining life, and lifecycle cost. Past mid-life is not a replacement rule.
Add retrofit systems? If the deck or plumbing is already open, compare doing the work now with demolishing those finishes later. That repeat-access cost is conditional. It is not a claim that renovation is always the cheapest moment.
Keep or change geometry Shape changes escalate to reconstruction; be deliberate

When access is already open, compare the remaining life and operating cost of the existing equipment with a coordinated replacement. ENERGY STAR’s pool-pump listings are a United States energy reference for certified pumps versus standard models. Project savings still depend on sizing, hydraulics, schedules, and controls. Use the pump sizing method before selecting a replacement. Do not copy a savings figure onto this project from the listing alone.

Evaluate each retained item against the proposed system, not only against whether it still runs today:

  • Does its rated flow and pressure range match the new hydraulic design?
  • Can replacement parts and qualified service still be obtained?
  • Will its controls communicate or interlock with the new equipment?
  • Can it be isolated and removed after new finishes are complete?
  • Is its remaining service life consistent with the planned shutdown cycle?
  • Are documentation, labels and electrical data available?

Record the reason for every keep, repair or replace decision on the survey table. That record gives the owner a usable plan for items intentionally deferred instead of allowing them to disappear from the renovation scope.

Deliverable: a keep, repair, or replace decision for each item, with the comparison that supports it.

Manage unknowns without hiding them

Renovation pricing should distinguish defined work, unit-rate work and allowances for concealed conditions. Identify the event that releases each allowance, such as opening a test area, pressure testing a line or removing a section of deck. Require written approval before the provisional scope expands.

Build the schedule around inspection points. Once finishes cover a pipe, conduit or structural repair, later verification becomes expensive. Photograph concealed work, record test results and obtain the required acceptance before the next layer proceeds.

Stage 3: Sequence

Use eight planning stages. The order moves when the shell, finish, or equipment manual, or the site, requires a different order. Keep the groundwater and shell-movement assessment in the method statement before draining.

Scroll horizontally to see all columns when the table extends beyond the screen.

Stage Depends on Acceptance Owner
1. Drain and protect Survey record and the groundwater and shell-risk assessment Water is controlled and retained work is protected Builder, with the owner
2. Structural repairs Stage 1 and the shell assessment Repairs accepted before they are covered Builder and the designer
3. Plumbing changes and pressure test Stage 2 where the shell is open Test result recorded Builder

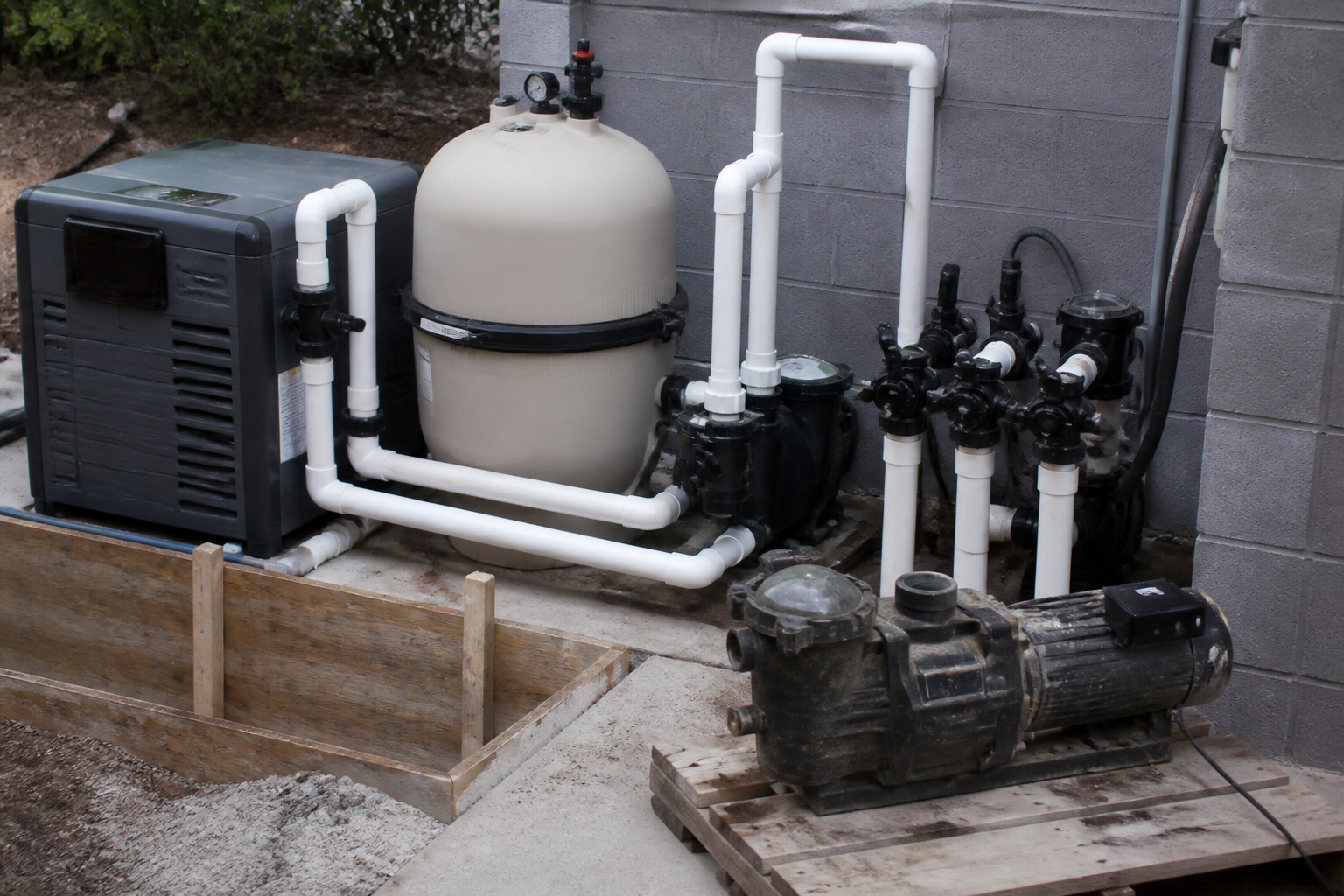

4. Equipment room and new equipment The keep, repair, or replace record Nameplates match the accepted schedule Equipment supplier and builder
5. Retrofit that touches shell or deck Stages 3 and 4 for shared routes Tracks, housing, and conduits accepted before finishes Builder
6. Surfaces Stage 5 accepted, so finishes are not cut for a known conduit Finish released by the finish instructions Finisher
7. Deck and coping Stage 6, unless the manual requires deck work earlier Falls and edges accepted Builder
8. Fill, commission, balance, document Stages 1 to 7 accepted Baseline readings in clean conditions Builder and the operator

The expensive planning error is finishing stage 6 before stage 5: cutting a new surface for a track or conduit that was already known. Deliverable: a stage table filled with the manual or site condition that changed the order, if any.

Protect retained equipment and finished areas throughout the sequence. Define who controls draining and refilling, how groundwater or shell movement risks are assessed, where demolition debris travels and which systems must remain available to the property. These are project-specific decisions that belong in the method statement, not assumptions left to the day work begins.

Stage 4: Documentation and handover

Update the drawings to as-built, collect manuals and warranties for everything new, and record commissioning values (flow, pressures, dosing settings). Structuring supplier scope and documentation from the first quotation onward follows the pool equipment RFQ guide, and related guides live in the Pool Renovation & Retrofit hub.

Before filling, close the inspection records for the shell, plumbing, electrical work, cover interfaces and finishes. During startup, test the intended operating modes, verify that retained and new equipment work together, and record baseline readings in clean conditions. Update valve labels and operating instructions to match the final arrangement.

The final package should also list deferred work, remaining service-life concerns and recommended review dates. A renovation often keeps part of the old system by design. Making those limits visible helps the operator distinguish an accepted future task from a new defect.

Close the planning check by returning to the survey record above and by writing the supplier scope in the pool equipment RFQ guide. Deliverable: the survey rows and the RFQ use the same keep, repair, and replace decisions.

Frequently asked questions

Should equipment be replaced during a surface renovation?

Do not replace an item only because it is past mid-life. Compare condition, compatibility with the new hydraulics, remaining service life, and lifecycle cost, including the cost of opening the finishes again later. A coordinated replacement can make sense when that comparison supports it.

What changes the renovation schedule?

Concealed defects, the result of tests before the pool is drained or opened, cure times, and added structural, deck, or retrofit work all change the schedule. This page does not state a duration, because the sources listed here do not give one. The existing question on this page asked for a duration; the answer now lists the variables instead of an unsourced number of weeks.
